Hwy 10, 29 and 71—Wadena construction

Wadena and Otter Tail counties

Know before you go: check 511mn.org

Current work zone

Information subject to change. News release (5/20)

Hwy 10 open: Wadena to west

Through fall

  • One lane each direction between Co. Rd. 4 and 620th Ave.
    • Expect lane shifts, no shoulders, head-to-head traffic and multiple crews at work
    • Business access is maintained, follow signs

Hwy 10 detour: Wadena to Verndale

Through early July

  • Road closed to through traffic from Co. Rd. 4 to east of Oink Joint Rd.
    • Detour: Co. Rd. 4 and Co. Rd. 23 (PNG)
      • Watch for a temporary all-way stop at Co. Rd. 4 and Co. Rd. 23
      • Expect delays and follow all work zone signs
      • Business access is maintained within the work zone, follow signs from the detour route
  • Hwy 10 open east of the closure
    • Enter/exit Hwy 10 from Verndale
      • Use U-turns to navigate eastbound/westbound Hwy 10
    • Please refrain from using gravel roads to cut across - this helps reduce dust, maintains slower speeds and keeps the road safely open for local businesses and residents

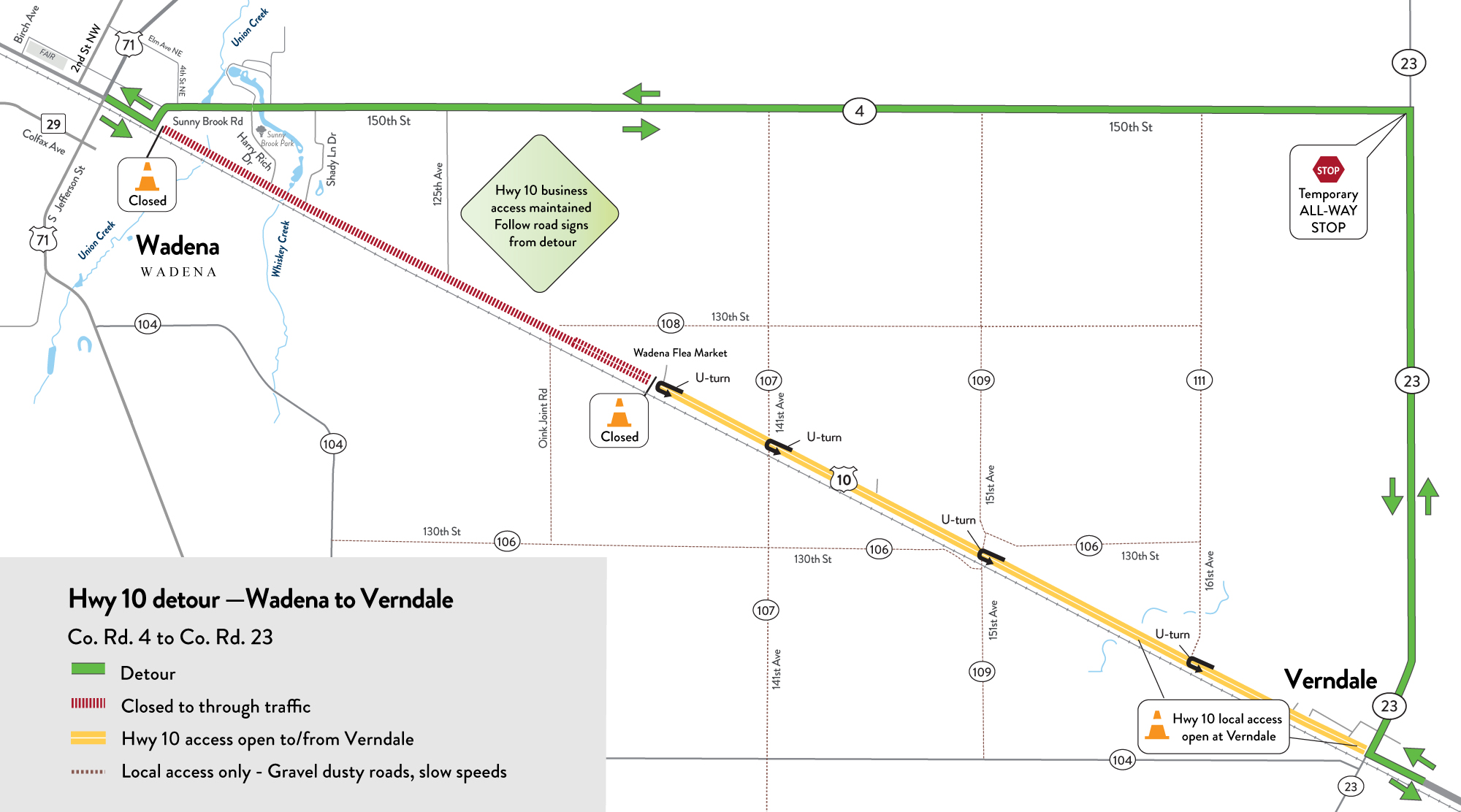

Detour map

Detour map Select map image to enlarge (PNG)

Upcoming

Hwy 29, Hwy 71 open: Wadena

Work begins after June 22

2026 work

April - late October

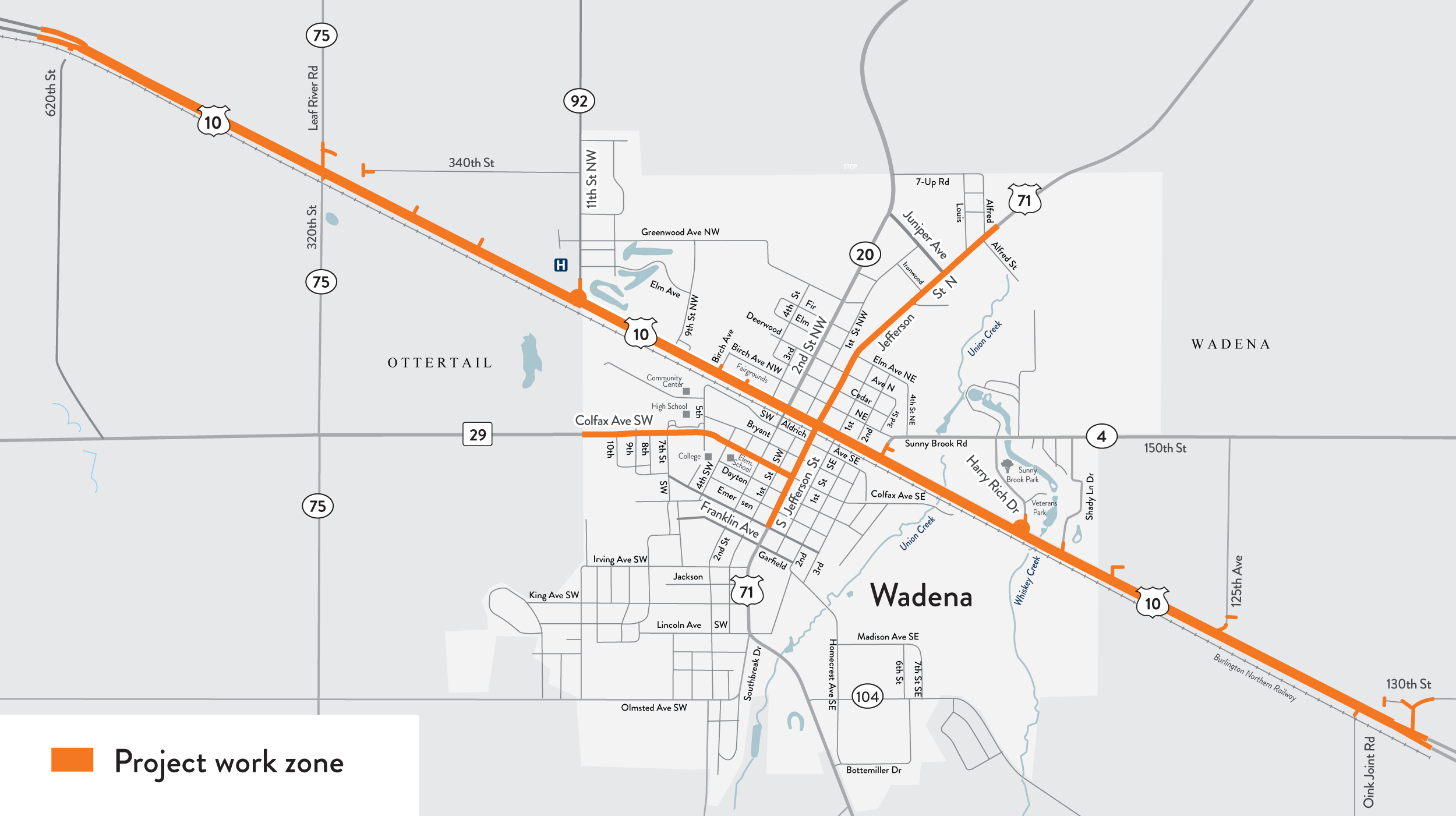

2025 work zone areas map
Wadena:2026 work zone map on Hwy 10, Hwy 29 and Hwy 71. Select map PNG to enlarge

Wadena is open

Access for those who live, work or visit areas along this project will be open and maintained at all times. However, expect these changes:

  • Hard closures at times; contact businesses prior to your visit
  • Use of a side streets, alleys or back/side entrances
  • Gravel or grooved surfaces or temporary entrances
  • Pedestrians will have sidewalk closures with detours

Expect major construction on Hwy 10 west of Wadena at 620th Ave., Otter Tail County, to east of Wadena at Oink Joint Rd./140th St., Wadena County, in 2026-2027.

Hwy 10 west of Hwy 71

  • Excavate and build up road materials; replace pipes; construct road, medians and entrances, J-turn at Co. Rd. 75 and second half of roundabout at hospital - Goal: Open to four lanes by late October

Hwy 10 east of Hwy 71

  • Excavate and build up road materials; construct segments of road, entrances, half of roundabout at Harry Rich Dr., and box culverts at Union Creek and Whiskey Creek

Hwy 71 south of Hwy 10

  • Franklin to Aldrich Ave. S (35 consecutive days within June 22-Sept. 8 time frame)
    • Resurface and update the road
    • Update or install sidewalks
    • Storm sewer work
    • Update or replace signals at Hwy 29, Bryant Ave. S, Aldrich Ave.

Hwy 29

  • Hwy 71 to west limits of Wadena (40 consecutive days within June 22-Sept. 8 time frame)
    • Resurface road
    • Update/add sidewalk
    • Storm sewer work
